PROPOSED PLANS

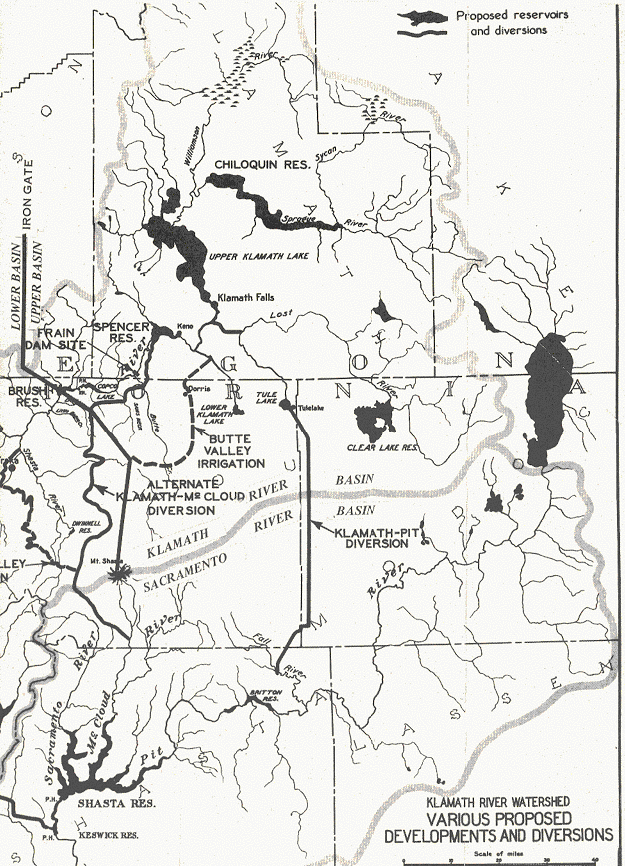

Diversions to
Plans for full utilization of
In
December 1944 the Civil Works Division of the War
Department detailed investigations covering water
and power utilization in the Klamath and
(1) The construction of a high dam on the Sprague
River above Chiloquin that would flood the entire
Sprague River basin and store seasonal runoff to the
amount of 1,200,000 acre feet. This water would be
released through the
(2) All of the Klamath Irrigation would be supplied
from the
(3) The
(4) An alternative line of diversion would be to
take the water from
(5) The
inflow in the Klamath River below Spencer Bridge was
considered adequate to take care of fish life, and
the program called for utilization of Copco No.1
reservoir with storage of about 77,000 acre feet for
release of a continuous flow of water below Copco
No.1 to take care of fish life and recreational
facilities on the river below.
(6) The value of Copco No.1 and No.2 as power
projects would be totally destroyed. The plan
contemplated that Copco would continue to serve all
of the areas then served, and that Copco would be
reimbursed for its capital loss and furnished with
firm power at cost from the Shasta dam, with a
reasonable severance damage and assurance of
additional capacity if and when needed.
(7) The estimated cost of the project, including
losses to be paid Copco and others was
$100,000,000.00.
In December 1944 there was an explosion, which shook
both the Upper and
On
"The proposed diversion, by removing most of their
water supply would practically destroy the value of
the existing power plants at Copco No.1 and Copco
No.2, and any rights that Copco may have for the
construction of other plants on the Klamath. The
right to use the proposed 520 feet of power head
above
Public hearings were held at
A legislative committee headed by State Senator
Randolph Collier made a valuable report summarized
as follows:
The California Legislature 56 session passed Senate
Concurrent Resolution No.18 Chapter 21, statutes of
1945 appointing a committee to investigate and

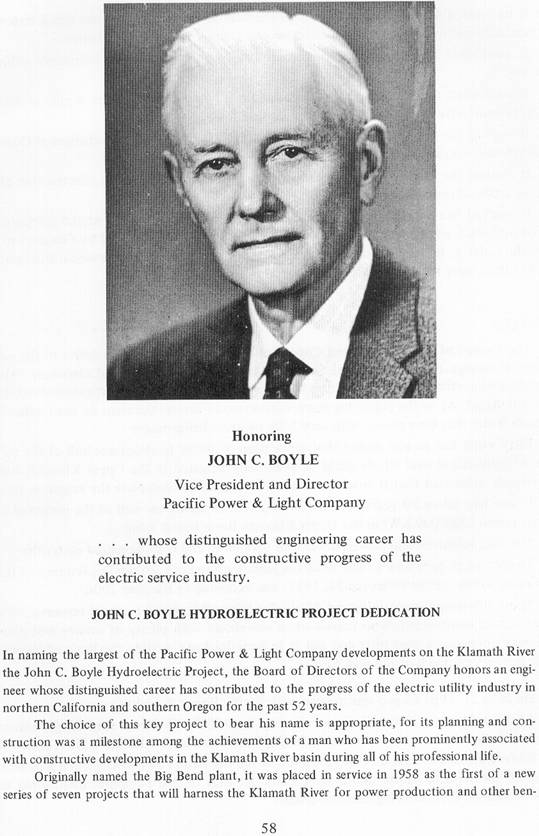

report its findings in connection with the
proposed Klamath and
Insofar as
(1) "The investigations being conducted in regard to
the Klamath River diversions by the Corps of
Engineers, War Department, are untimely and uncalled
for and are not supported by any local interests
whatsoever."
(2)
"Preliminary studies indicate that further water
requirements of the Upper Klamath basin will make it
necessary to develop practically all of existing
water supply within the Klamath River basin."
And it was recommended that:
(1) "The Bureau of Reclamation should be requested
by local residents to investigate water requirements
of the entire Klamath River Basin giving full
consideration to the irrigation, power, fish, and
wildlife, recreational and other beneficial uses for
water."
(2) "Investigation by the Corps of Engineers should be discontinued without further unnecessary expenditure of public funds."
BUREAU OF
RECLAMATION PLAN
In June 1954 the Bureau of Reclamation completed a
preliminary study of the
This study included reports from the Bureau of
Indian Affairs, Fish and Wildlife Service, National
Park Service, Bureau of Mines, Forest Service,
Bureau of Land Management and Bonneville Power
Administration. It was very complete in reviewing
the status of developments which had taken place to
date and it outlined a comprehensive plan for
utilizing the remaining resources of the basin for
the benefit of all interested agencies.
The important changes suggested in the plan were:
(1) To include
(2) To include power development by the Bureau of
Reclamation by diverting
As
The Bureau of Reclamation changed its plans with
respect to irrigating the
THE COPCO PLANS
Canyon Project
Power development in the
Copco's
plan followed very closely the requirements of the
Federal Power Commission, namely that an application
must include a proposal to develop and utilize all
the power re- sources of the area.
On May 9, 1921, application was made to the Federal
Power Commission for permission to investigate a
stretch of river about 10 miles in length lying in
Oregon immediately above the state line, for the
purpose of the ultimate development of about 320,000
KW between Keno and Iron Gate. The Federal Power
Commission issued a permit No.215 on
On May 12, 1921, application was made to the State
Engineer of Oregon to appropriate 1500 second feet
of water for the development of 7.0,000 THP
(theoretical horsepower), application No.7894, on
this same stretch of river. Permit was not issued by
the State Engineer for the reason that the Attorney
General of Oregon had rendered an opinion that those
waters were not subject to appropriation having been
transferred to the
As time passed, engineering studies were completed
and the preliminary layout of projects submitted
with revised applications to the Federal Power
Commission and the State Engineer of Oregon.
The original state filing No.7894 was changed and
new filings made as follows:
Canyon Project No. 13603- 28,295 THP
Big Bend No. 13604- 65,455 THP
original No.7894
Grant No.2 No. 13605- 36,477 THP
Grant No.3 No. 13606- 17,045 THP
Grant No.4 No. 13607 -34,091
THP
181,363
These applications were before the State Engineer
for approval and Copco asked that the Canyon Project
be approved for construction. The Company had
appropriated $4,000,000.00 and had received a
preliminary license from the Federal Power
Commission. This preliminary license was recalled
when the FPC was advised that Copco had not been
granted a permit for use of the water from the
state.
Legal questions arose as to whether or not the state
"could issue any permits for appropriation of any of
the waters within the
The governor and his staff delayed further action
until the act creating the Hydroelectric Commission
of Oregon had become effective.
The Hydroelectric
Act of
Copco did not transfer its applications on the
The Company then transferred its activities to the
The applications to develop the
The
In 1890, a dike was built to prevent overflow of
In 1906 and 1907, the Southern Pacific Railroad was
required to install headgates at Ady so flow of
water to and from
In 1919, with the beginning of regulation of the
No particular problem occurred until 1927 when a
large discharge in
The Bureau of Reclamation had in mind enlarging the
A needle dam was completed
Langell Valley Lands
In 1924, a year of extremely low water, Copco needed
additional water for generation of power at Copco
No. 1 power plant.
Arrangements were made with the Bureau to purchase
60,000 acre feet at $.20 per acre foot with the
responsibility on Copco to run it through
The old original channel of
The Langell Valley Irrigation District board in 1926
planned to have the Reclamation Service construct a
drain through the valley at an estimated cost of
$50,000.00, but were un- able to obtain right of way
over the Swingle property. It was suggested that
Copco acquire this land, grant the right of way to
the district, and in consideration receive from
the district a contract permitting future use of the
drainage ditch by the company.
This was done. The necessary improvements were made
and Copco obtained the right to pass water over the
diversion dam of the district, through
Copco made no power developments in the
It had however kept up with its load growth by
developing power elsewhere, at:
Prospect 2,3 and 4 on the
4 Diesel
plants
1,035 KW
Alturas
hydroelectric
450 KW
Toketee - 8 plants on the
(2 under
construction)
200,000 KW
Total 241,685 KW
Upon completion of the last of the Toketee plants by
1956 other plants needed to be constructed shortly
thereafter. In the early '20s Copco system load
increased at about 4,000 to 5,000 KW per year. By
1957 this increase jumped to about 10,000 and 15,000
KW per year.
So filings were made on the
However,
The creation of the Hydroelectric Commission of
Oregon in 1931 with amendments of the Legislative
Act made it possible for a power company to obtain a
license similar to a Federal Power Commission
license for use of water in
In 1951, the Klamath community was advised that a
power plant would be built on the
On
Because of the need to construct larger power
developments adequate to meet the system demands,
the plans were changed to combine two of the
original projects with one of 88,000 KW capacity.
The purpose of applications at this time, perhaps
four or five years in advance of need, was to
determine what if any legal complications would
arise which would delay the development or make it
impossible to construct the plant. Based upon the
experiences during 1925 to 1930 in Klamath regarding
water rights, the outlook was not optimistic.
A plan was submitted covering development of the
remaining undeveloped projects between Keno and
Practically all the irrigation districts in the
Klamath Reclamation Project joined in filing
protests. The Secretary of Interior filed a protest,
as did the Bureau of Reclamation and many
individuals.
During the following months some resolutions
favoring the project were filed. The Oregon State
Federation of Labor at convention in
The deadline date for filing protest with the
Federal Power Commission was
On Friday, September 7, 1951, the State
Hydroelectric Commission stated that no further
hearings would be held and it was satisfied that if
Copco could work out an agreement with the
Bureau of Reclamation for an extension of the
contract to regulate the Upper Klamath
Hearings were held
before the Federal Power Commission on June 3 and 4,
1952 and
So on
In May 1953 Copco completed negotiations with the
Bureau of Reclamation to purchase the output of the
Bureau's new 18,500 KW Greensprings plant on the
system of the Talent Irrigation District (
On
On August 5, 1955, the draft of a contract between
the Department of Interior and Copco covering
regulation of Upper Klamath Lake, pumping rights for
the Klamath Project, water uses and other associated
provisions were submitted to all interested parties
and comments requested by September 1, 1955. If a
contract was signed, copies were to be filed with
the Federal Power Commission, Hydroelectric
Commission of Oregon and the Public Utility
Commissions of Oregon and
In a meeting in Sacramento September 28, 1955, a
letter from Copco to the Oregon and California River
Compact Commissions stated in part "that no Klamath
water shall be used by Copco when it may be needed
or required for use for domestic, municipal, or
irrigation purposes within the Upper Klamath River
Basin as defined in the compact; Provided nothing
shall curtail or interfere with the water rights of
Copco having a priority earlier than May 19, 1905;
Provided further that all drainage and return flows
shall be at a point above Keno."
The new agreement between Copco and the Bureau of
Reclamation was completed January 3l, 1956. Work was
authorized to start in June 1956 and Copco had
obtained the unanimous support originally requested
in 1951.
The
.
Dam: The dam is located on the
Reservoir: The reservoir capacity is 3,377
acre-feet, 1,397 acre-feet of which will be usable
pondage. The normal water surface elevation is
3,793.0 feet with a normal low water surface of
3,788.0 feet. The reservoir extends upstream for a
distance of approximately 3 miles.
Tunnel: 74.50 feet -steel lined -16-foot
diameter.
1,587.72 feet -concrete lined -16-foot
diameter, horseshoe shape.
Waterways: 15.25 feet of concrete intake.
638.41 feet of 14'0" I.D. steel pipe
crossing the
49.59 feet of 14'0" concrete conduit.
36.00 feet of concrete transition.
6,271.62 feet of two wall concrete flume.
4,489.13 feet of one wall concrete flume.
340.00 feet of concrete forebay.
1,587.72 feet of concrete lined tunnel -16'0" diameter
74.50 feet of steel lined tunnel -16'0" diameter
(to the centerline of the surge tank.)
Total length -2.56 miles.
Penstock: The surge tank at the upper end of
the penstock is 56.0 feet in height and 30 feet
in diameter (I.D.). The twin steel penstocks are
957.68 feet in length (true dimension, centerline of
surge tank to centerline of unit, with inside
diameters varying from 10'6" to 9'0" and plate
thicknesses varying from 3/8" to 15/16".
Head and Diversion. Maximum static head -454 feet.
Normal net
effective head -440 feet.
Normal diversion
-2,500 cubic feet per second.
Power Plant: The power plant consists of two
General Electric vertical generators each 42,100 KVA,
95% power factor, 3 phase, 60 cycle, 11,500 volt,
277 R.P.M. Nameplate rating 79,990 KW. The two
Baldwin, Lima, Hamilton Corporation turbines are
rated 56,000 H.P. each and are equipped with Pelton
Type B Hydraulic governors. Capability is rated at
88,000 KW.
Substation: The power generated at 11.5 KV is
transformed to 230 KV by two General Electric 42,300
KV A, 3 phase transformers which, together with the
associated electrical equipment, are located
adjacent to the power plant.
Transmission: A 230 KV transmission Line
No.59 connects the plant with the Company's existing
system at
The
On
Dam: The dam is located on the
Reservoir: To be operated essentially as a
re-regulating reservoir. The reservoir capacity is
approximately 58,000 acre-feet. The normal operating
water surface elevation is 2,328 feet with a normal
low water surface elevation of 2,324 feet.
Tunnel: A 16-foot horseshoe shape tunnel,
969.2 feet in length under the right abutment of the
dam. Will serve as a sluice and diversion during
construction.
Penstock: 12-foot I.D. steel pipe through
dam. Length -681.26 feet.
Head and Diversion:
Normal Net Effective Head -154 feet.
Normal Diversion
-1,650 cubic feet per second.
Power Plant: One vertical reaction turbine
rated at 25,000 H.P., direct connected to an 18,000
KW generator.
Substation: A substation adjacent to the
powerhouse will contain a 3-phase transformer
capable of stepping up the generator output voltage
to 66 KV.
Transmission: A transmission line of standard
wood pole construction will connect the sub- station
with the applicant's existing transmission system at
the Copco No.2 switchyard.
Roads: The reservoir will inundate some of
the existing county road and approximately 61/2
miles will be relocated by the company. Upon
completion of the project, the new road will be
owned and maintained by the county.
Fish Facilities: In conjunction with the
State of
It was built where the iron colored bedrock stood
almost vertically 250 feet above the river, and
served as a control point.
It had iron
eyebolts drilled securely in the bedrock to hold log
booms, which impounded and released logs from
upstream as needed for the sawmill at Klamathon
below.
It controlled the one-way county road cut in a
bedrock shelf frequently subject to overflow.
It controlled the Klamath Lake Railroad at its
five-mile post where a mile of 4% grade had to be
built adverse to upstream freight hauling.
It marked the control of water surface fluctuations
caused by load changes at Copco No.2 powerhouse,
which had affected the river below.
It marked the end of fish migration from the
It marked the time when the States of California and
SUMMARY
The Bureau of Reclamation and Copco continued to
make studies relative to the value of additional
storage of water at
Fifty years had passed during this application of
water to about one-half of the 600,000 acres of
agricultural land, which could be eventually
irrigated in the
It also had taken 50 years for the development of
about one-half of the potential hydro- electric
power (320,000 KW) in the
The two, irrigation and power, developed parallel to
and complimented each other.
Twenty years have now passed since the joint venture
between the Department of Interior and Copco, which
started
Those interested in retaining and developing
Klamath's greatest natural resource, "Water," should
not be complacent. Who knows when somebody with
plenty of money and plenty of votes may appropriate
part of it and put it to beneficial use outside the
basin of its origin? It is still the envy of much of
the arid West.
On
Rededication was held on
A native of
John C. Boyle's first job was field surveying for
the Siskiyou Electric Power & Light Company. It led
to his assignment in 1916-1918 as the superintendent
of construction of a 135-foot- high dam and the
20,000-kilowatt Copco No.1 powerhouse by a successor
company, The California Oregon Power Company, at a
site he had located during his first survey work.
The concept of providing for regulation of Upper
Klamath Lake and reclamation of marsh lands was made
feasible a few years later when he completed the
engineering and building of the Link River Dam in
Klamath Falls. Together with related channel
dredging and diking, the dam has made it possible to
greatly expand the basic agricultural economy of the
region.
During the decades of the 1920s and 1930s, he
devoted his engineering talents to building the
modern electric power system that has served the
growing area so well. In this period he also
investigated the hydroelectric potential of the
Klamath, Rogue and
Mr. Boyle became the Vice President and General
Manager and Chief Engineer of The California Oregon
Power Company in 1941. Beginning in 1945 he guided
the Company into a decade of record expansions of
its generating capacity. The work centered on the
While completing the
It is very appropriate that a dynamic and useful
development such as this hydroelectric project
should carry his name in recognition of his
outstanding engineering services to the Company and
as a testimonial to the qualities of leadership he
has given to the task of building the region it
serves.
Presented to Luncheon Program Guests
Winema Hotel,
|
Home
Page Updated: Thursday May 07, 2009 09:14 AM Pacific
Copyright © klamathbasincrisis.org, 2005, All Rights Reserved
